How to Charge for Variations and Stop Doing Extra Work for Free
The words to use on site, which extras to price and which to give away, when a variation has to be in writing in your state, and how to get every extra onto the invoice.
In this article
You've finished the job, packed the tools, and the customer says it: "While you're here, could you just have a look at the light in the hallway?"
Most tradies say yes. It's ten minutes, and asking for money feels petty. Then it happens on the next job, and the one after. By Friday you've done half a day of work nobody will pay for, and none of it is written down.
That's how variations leak. Not in big disputes on big builds, but in small extras that never get a price, never get recorded and never reach the invoice.
This guide shows owner-operators and small crews doing residential work how to charge for variations: which extras to price, what to say on site, when your state requires a variation in writing, and how to get every extra onto the final invoice.
What is a variation? The short answer
A variation is any change to the work you quoted: extra work, different materials, or something taken out. To get paid for one, agree on the price with the customer before you do the work, record it with the date, and list it as a separate line item on the invoice. For home-building work above your state's value threshold, any variation usually must be in writing and, in most states, agreed upon before the work starts.
How much do unbilled extras cost a tradie?
Unbilled extras cost tradies more than most think, because each one looks too small to matter.
Nobody has measured this in Australia yet, but the UK has. In a Simply Business survey of 408 UK tradespeople in May and June 2026, 92% said customers had asked them for work beyond the original booking, and 62% said it happens regularly. On average, they spent 1.8 hours per week on unpaid extra work, and over a third said they never get paid for it at all.
1.8 hours a week is 93.6 hours a year. At $100 an hour, that's about $9,400 of work given away, before you count the parts.
To work out your own number:
Here's an example. The numbers are illustrative, so plug in your own.
- You do three small extras a week that never get billed: a power point here, a tap washer there, an hour patching a wall.
- Each one is worth about $90 in time and parts.

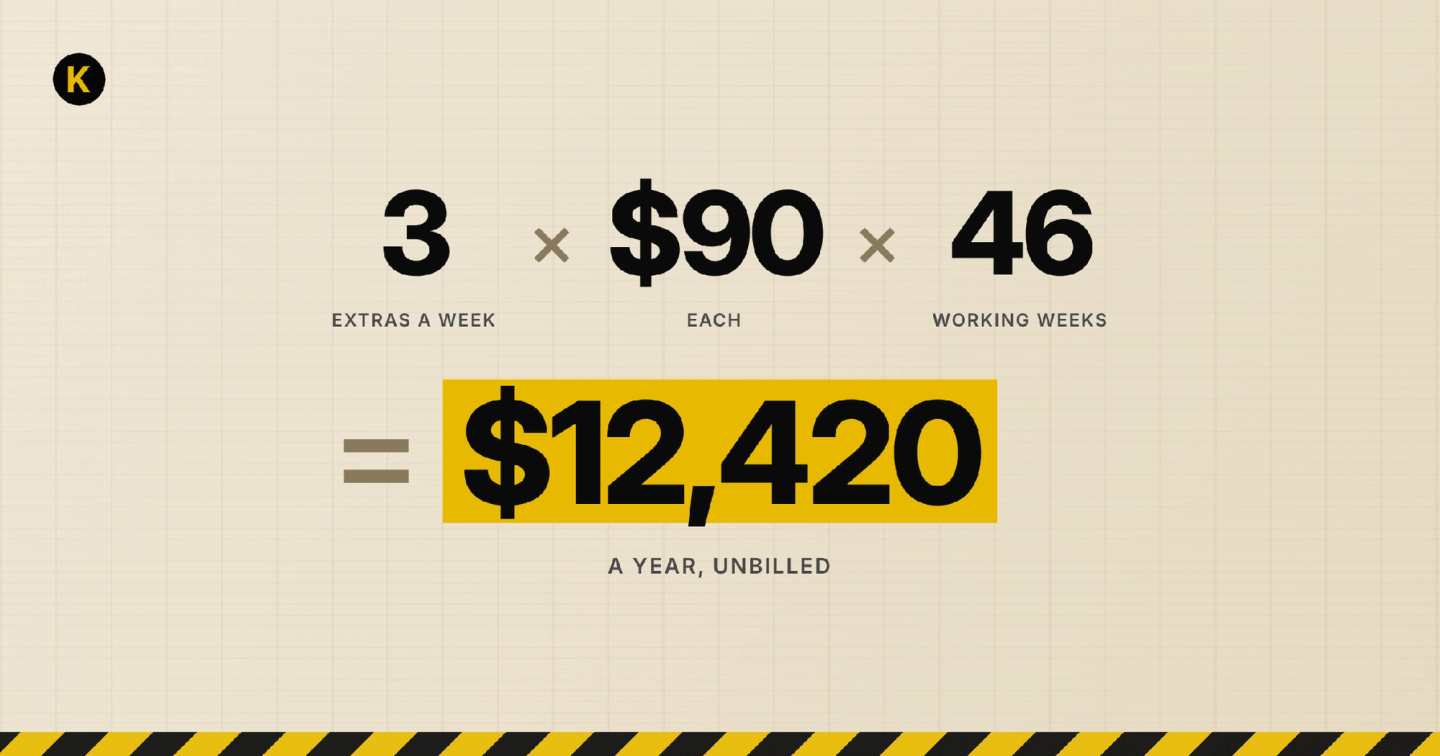

- Over 46 working weeks, that's $12,420 a year.
That hurts more than losing a job. An extra you don't bill has already cost you the time and the parts, so every dollar of it comes straight off your profit.
Why do good tradies end up working for free?
The moment. Extras get asked for when you're mid-job or packing up, and stopping to price a ten-minute job feels like more effort than the job.
The awkwardness. Asking for $60 after a friendly chat feels mean, so you say "no worries" and move on.
No system. The extra lives in your head until the invoice gets written, often days later. By then, it's forgotten, or you're not sure what you agreed to.
The UK survey found an upside too: 62% of tradies said helping beyond the job had led to recommendations. Goodwill works. The problem isn't doing favours. It's doing them invisibly, so you get neither the credit nor the record.
Asked, found or offered: which kind of extra is it?
Every extra on a job comes from one of three places. Work out which one you're dealing with, and you'll know what to do next.
Asked: price it before you pick up the drill
The classic "while you're here". The customer asked, so all that's missing is a price. Say it out loud, as a total, before you start. Then confirm it and record it. Mark up variations the same way as the quote, or every extra lowers your margin.
Found: stop, show, then price
Hidden problems are the variations customers are most likely to question later, because they didn't ask for them. So make them visible: stop, show the customer, take a photo, and explain what it costs to fix properly. Get their OK before you carry on. If something is unsafe, make it safe first. Queensland's rules allow for genuinely urgent work, but the written variation still has to follow.
Offered: quote it, don't start it
This is the one most tradies get wrong without knowing it. If you suggest extra work at the customer's home and they agree on the spot, it may be an unsolicited consumer agreement under the Australian Consumer Law. South Australia's Consumer and Business Services uses exactly this example. Over $100, the rules for unsolicited agreements require a written agreement and a 10-business-day cooling-off period, and, with very limited exceptions, you can't do the work or accept payment during that time.
The fix: when the extra is your idea, and it isn't urgent, quote it and let the customer come back to you. CBS says a customer who calls to go ahead after getting your quote isn't an unsolicited sale. It also takes the pressure off, which customers remember.
What do you say when a customer asks for extra work?
Keep it short and friendly, with a number in it. The aim is to make the price a normal part of the conversation, because it is.
"Yep, can do. That's not in today's quote, so it's $180 a point, $360 for the two, on the final bill. Want me to go ahead?"
"Before I go any further, come and have a look at this. The floor's rotten under the old tiles, so I can't tile over it. Fixing it properly is $450 extra. Do you want me to go ahead, or have a think first?"
"While I was up there, I noticed your downlights are the old halogens. LEDs would be about $65 each. No rush on that one. I'll put it in a quote, and you can let me know."
"We didn't need the second coat on the ceiling in the end, so I've taken $220 off."
Then confirm it in writing the same day. For most small jobs, a text does it:
Hi Mark, Dave here. Just confirming the extra from today: two double power points in the kitchen, $360 plus GST, added to your final invoice. Any questions, give me a call.
One text turns "I'm sure we talked about it" into a dated record. For larger jobs covered by your state's building contract rules, a text alone may not be enough. That's the next question.
Do variations need to be in writing?
Variations on home-building work usually need to be in writing once the job exceeds a value threshold, and each state sets its own threshold. Here's how they compare as of October 2026.
| State | When the rules apply | What they say about variations |
|---|---|---|
| NSW | Residential building work over $5,000 incl. GST | Must be in writing and signed by both parties. |
| QLD | Domestic building work over $3,300 incl. GST | In writing, and agreed by the owner in writing before the work starts, unless it's genuinely urgent. The owner gets a copy within 5 business days, or before the work starts if that's sooner. You can't ask for payment before the variation work starts. |
| VIC | Major domestic building contracts, over $10,000 | Agreed in writing with a Variation Notice before the work starts. Exception: owner-requested changes you reasonably believe won't need a permit change, won't cause delay and won't add more than 2% to the original price. |
| WA | Fixed-price home building contracts, $7,500 to $500,000 | In writing, dated and signed by both parties, with a copy to the owner before the variation work starts, with some exceptions. |
| SA | Domestic building work contracts over $20,000 (up from $12,000 in November 2025) | Variations the owner asks for must be agreed to in writing. Check your contract for how other changes are handled. |
| TAS | Residential building work of $20,000 or more | In writing and signed by both parties before the work starts, unless urgent or unforeseeable. The owner gets a copy within 5 business days. |
-
NSW
- When the rules apply
- Residential building work over $5,000 incl. GST
- What they say about variations
- Must be in writing and signed by both parties.
-
QLD
- When the rules apply
- Domestic building work over $3,300 incl. GST
- What they say about variations
- In writing, and agreed by the owner in writing before the work starts, unless it's genuinely urgent. The owner gets a copy within 5 business days, or before the work starts if that's sooner. You can't ask for payment before the variation work starts.
-
VIC
- When the rules apply
- Major domestic building contracts, over $10,000
- What they say about variations
- Agreed in writing with a Variation Notice before the work starts. Exception: owner-requested changes you reasonably believe won't need a permit change, won't cause delay and won't add more than 2% to the original price.
-
WA
- When the rules apply
- Fixed-price home building contracts, $7,500 to $500,000
- What they say about variations
- In writing, dated and signed by both parties, with a copy to the owner before the variation work starts, with some exceptions.
-
SA
- When the rules apply
- Domestic building work contracts over $20,000 (up from $12,000 in November 2025)
- What they say about variations
- Variations the owner asks for must be agreed to in writing. Check your contract for how other changes are handled.
-
TAS
- When the rules apply
- Residential building work of $20,000 or more
- What they say about variations
- In writing and signed by both parties before the work starts, unless urgent or unforeseeable. The owner gets a copy within 5 business days.
Sources: summarised in October 2026 from the NSW Government, QBCC, Consumer Affairs Victoria, the WA Government, Law Handbook SA, and the Tasmanian Act. In the ACT and NT, check with your regulator. This is a plain-English summary, not legal advice. Which trades and jobs are covered, and what the exceptions are, vary by state.
Most small jobs sit under these thresholds. That doesn't make a verbal variation safe. If it's disputed, a dated text with the price is what gets you paid.
Extras can push a small job over the line. The QBCC's small building projects contract warns that if variations take the total past $3,300, obligations such as home warranty insurance may apply. Watch the running total, not just the extra.
Over the threshold, a text isn't the whole answer. Rules in Queensland and Victoria set out what the variation document must contain and require the owner's written agreement before the work starts. The QBCC publishes free variation forms with its contracts.
How do you make sure extras end up on the invoice?
Pricing the extra is half the job. The other half is making sure it's still there when you write the invoice.
Log it when it happens. Record each variation on the day: the date, what it was and the agreed price. Anything left in your head until invoice day is at risk.
Give each variation its own line. "Additional work: $940" is the line customers query first. "VAR-0001: 2 x double power point, kitchen: $360" is one they recognise and pay.
Bill the favour at $0. If it took two minutes and no parts, do it, but put it on the invoice anyway: "Replaced two tap washers, laundry: no charge." The customer sees the favour, and you've got a record of what you did. Set your free-favour limit in advance, say under ten minutes and no parts.
Show credits too. A credit line for work you didn't need to do makes every other line easier to trust.
Bill variations as you go on long jobs. If a job runs over a few weeks with progress payments, add agreed variations to the next payment so they don't pile up into one big surprise.
What's the best way to record a variation?
There's no single right way to record a variation. What matters is that it's priced, dated and still there when you write the invoice. Here's how the usual options compare.
| Method | How it works | Best for | Watch out for |
|---|---|---|---|
| Memory | You remember it and add it when you write the invoice | Nothing beyond a two-minute favour | Gone by Friday, and no record if it's disputed |
| Paper docket or notebook | Written on site, sometimes signed by the customer | Tradies who already carry dockets, and signed variations on regulated jobs | Gets lost, and has to be retyped onto the invoice |
| Text to the customer | Description, price and date sent the same day | Small jobs under your state's threshold | Not a full variation document on regulated jobs |
| Job management app (such as ServiceM8, Tradify or Fergus) | The change is raised in the app as part of the job | Crews already running scheduling and dispatch in the app | More screens on site, and more software than you need if billing is the only problem |
| Korda Pro | A voice note on site, logged against the job and added to the final invoice | Owner-operators who want every extra billed without typing | Doesn't collect signatures, so use a signed form where your state requires one |
-
Memory
- How it works
- You remember it and add it when you write the invoice
- Best for
- Nothing beyond a two-minute favour
- Watch out for
- Gone by Friday, and no record if it's disputed
-
Paper docket or notebook
- How it works
- Written on site, sometimes signed by the customer
- Best for
- Tradies who already carry dockets, and signed variations on regulated jobs
- Watch out for
- Gets lost, and has to be retyped onto the invoice
-
Text to the customer
- How it works
- Description, price and date sent the same day
- Best for
- Small jobs under your state's threshold
- Watch out for
- Not a full variation document on regulated jobs
-
Job management app (such as ServiceM8, Tradify or Fergus)
- How it works
- The change is raised in the app as part of the job
- Best for
- Crews already running scheduling and dispatch in the app
- Watch out for
- More screens on site, and more software than you need if billing is the only problem
-
Korda Pro
- How it works
- A voice note on site, logged against the job and added to the final invoice
- Best for
- Owner-operators who want every extra billed without typing
- Watch out for
- Doesn't collect signatures, so use a signed form where your state requires one
How do you stop extras catching you out?
The cleanest variations start with the quote. If it says what's included and what isn't, a variation is obviously a variation.
Add an exclusions line to every quote listing what you haven't allowed for, such as patching and painting after electrical work, rubbish removal, or anything hidden behind walls. Then add one sentence: "Any extra work or changes will be priced and agreed with you before we do them." It sets the expectation before the first "while you're here", so on site you're just doing what you said you'd do. And if quotes are going quiet before you get that far, here's how to follow up a quote.
How does Korda Pro handle variations?
Korda Pro is quoting and invoicing software for Australian trade businesses that turns a voice note into a quote or invoice, then chases the customer until the job is paid. Variations work the same way: by voice, from site.
When the job changes, send a WhatsApp voice note while you're standing there: "Variation for the Smith job, two extra double power points in the kitchen, $180 each." Korda Pro logs it against the job with its own number, such as VAR-0001, and confirms it in the chat.
When you invoice the job, each logged variation is automatically added as its own line item, and the invoice is saved to Xero. Credits come off the total the same way. Ask "What extras have I logged for Smith?" at any time to see the list.
Korda Pro records variations so they get billed. It doesn't collect your customer's signature, so use a signed variation document where your state requires one. And it isn't job management software. It looks after the part of the business that turns work into money.
Setup takes under 20 minutes, with a 14-day free trial and no credit card.
What variation mistakes should you avoid?
- Doing it first and pricing it later. If the invoice is the first time the customer hears the price, you're negotiating after the work is done.
- Lumping extras into one line. "Additional work" with no detail is the line that gets queried.
- Trusting your memory. The extra you'll definitely remember is the one that's gone by Friday.
- Leaving credits off. Customers notice, and it makes the rest of the invoice look less trustworthy.
- Missing the running total. A few small extras can push a job over your state's contract threshold.
Variations FAQs
Can I charge for extra work that wasn't on the quote?
Yes, if the customer agreed to it. Give the price before you start, confirm it in writing and add it to the invoice as its own line. Work done without an agreed price is much harder to recover if the customer disputes it.
Do variations need to be in writing in Australia?
In most states, variations to home-building work above a value threshold must be agreed to in writing, usually before the work starts. Thresholds range from $3,300 in Queensland to $20,000 in South Australia and Tasmania. Below them, a written record is still your best protection.
Is a text message enough to confirm a variation?
For small jobs, a text with the description, price and date is a good record. For jobs covered by your state's building contract rules, the law may require a variation document with specified contents, signed by both parties, before work begins.
Can I do extra work I suggested straight away?
Be careful. If you suggest extra work at the customer's home and they agree on the spot, it can be an unsolicited consumer agreement, which, if over $100, brings a 10-business-day cooling-off period. Unless it's urgent, quote it and let the customer come back to you.
What if a customer won't pay for a variation?
Start with your record: what was agreed, the price, the date and any written confirmation. Most disagreements settle once the customer sees it laid out. If not, your state's fair trading or building regulator offers dispute resolution for home building work.
How do I keep track of variations without paperwork?
Record each one on the day it happens. That can be a text to the customer, a note in your job app, or a voice note to Korda Pro, which logs the variation against the job and adds it to the final invoice automatically.
The bottom line
Extra work isn't the problem. Extra work without a price, a record and its own line on the invoice. Price it before you start, confirm it in writing, and bill it as its own line, even when the line says $0.
Do that on every job and "while you're here" stops being a favour you quietly absorb and becomes work you get paid for.
